Lakeshore Drive Infrastructure Improvements

Description:

Phase 1A: Due to the proximity to the lake and recent landslide remediation’s along the lakeshore, the replacement of the underground utilities (water, sewer and Storm) posed the potential to destabilize the embankment. Therefore, the embankment has been reinforced with a sheet pile sea wall to reduce the risk of future slides.

Phase 1B: with the sheet pile sea wall established from Phase 1A the replacement of the underground utilities will take place and it will also allow for additional green space to be created overlooking the lake. Updates will also be made to the flow of traffic, overall parking plan, walkability and visual appeal of Lakeshore Drive.

The project can be broadly classified into three main components:

  1. Slope stability improvements – sheet pile sea wall.
  2. Infrastructure improvements – roads, underground pipes, drainage improvements.
  3. Landscape enhancements - develop the corridor as a linear parkway connecting Kinosoo Beach and Cold Lake Marina.

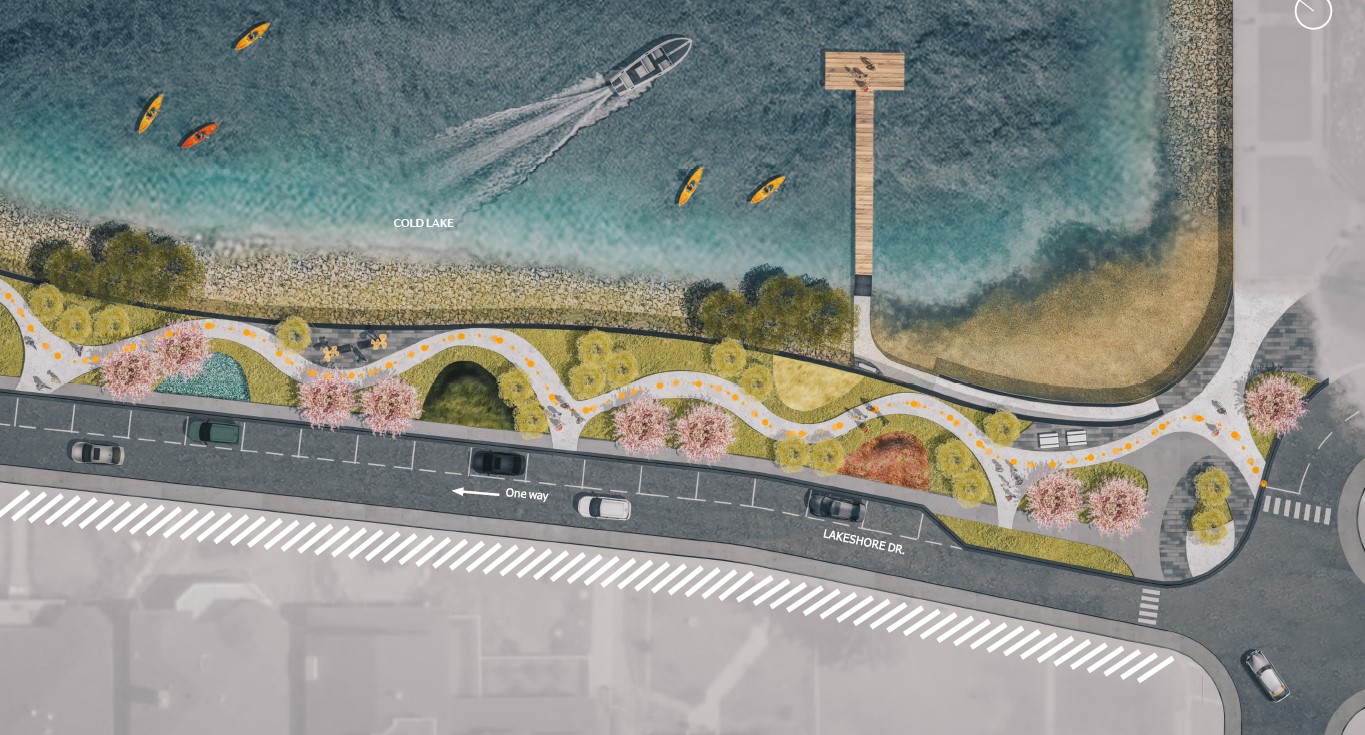

See how the project will look after completion. Use the slider to see the before and after views.

Location:

Lakeshore Drive (7 Street to 2 Avenue).

Updates:

Phase 1A:

Phase 1 A project complete as of July 2024.

Phase 1B:

October 2024: Underground Improvements Completed

October 2024: Curbs and gutters completed for Lakeshore Drive from 7th Avenue to 10th street

October 2024: First Lift of asphalt completed on Lakeshore Drive From 7th Avenue to 5th Avenue.

Schedule:

Phase 1A

  • August 2024: Construction completed

Phase 1B

  • October 2024: First lift of asphalt to be completed
  • Spring 2025: Second loft of asphalt to be completed
  • Summer 2025: Landscaping improvements to be completed 2025

Background:

The Lakeshore Drive Infrastructure Improvement Project was initiated in 2019 to improve the deteriorating underground utilities, road surface conditions, and slope along the lakeside. Another key component of the project is to establish and extend the Lakeshore Drive corridor as a continuation between the existing architectural and landscape themes at Kinosoo Beach to the Cold Lake Marina. The understanding is that all three areas (Beach, Marina and Lakeshore Drive) together would not only provide an attraction to the local community but can also be developed into a tourism destination attracting people from outside the region.

Budget:

Budget:

Total budget allocated: $27,550,000.00

Phase 1A

Estimated Project Closing Cost: $12.20 Million
Approved Budget: $14.00 Million
2019 CLAWR – $0.5 Million
2021 CLAWR – $6.00 Million
2022 CLAWR – $1.50 Million
2023 CLAWR – $3.50 Million
2023 MSI - $1.86 Million
2023 Restricted Surplus - $0.642 Million

Phase 1B

Estimated Project Closing Cost: $14.20 Million
Approved Budget: $14 Million
2024 CCBF - $2.03 Million
2024 LGFF - $1.94 Million
2024 Unrestricted Surplus - $4 Million
2024 Transfer from Operating budget - $0.317 Million
2024 CLAWR - $0.21 Million
2025 CLAWR - $3.25 Million
2025 LGFF - $1.56 Million



How will this benefit the community?

This project will enhance the view of the lake and accessible touch points will be created to allow the public easy access to the water. Additionally, a wider trail will be installed in the larger green space that will be created by the seawall.

Strategic Alignment:

This project is aligned with the strategic plan as it will increase tourism and accessibility to the lakeshore district and will promote development along the lake.

Traffic Flow Changes

Lakeshore Drive from 7 Avenue (Clarks) to 2 Avenue and 10 street (Water Treatment Plant) will be switching to a one way street. Traffic will be directed left at the intersections of 5th and 6th avenue and Lakeshore Drive. Parking will be implemented on the right hand side of the driving lane and the through lane will be on the left side of the road. Do not enter and one way signage have been installed to help with this transition.

FAQ

Due to the proximity to the lake and recent landslide remediation’s along the lakeshore, the replacement of the underground utilities (water, sewer and Storm) posed the potential to destabilize the embankment. Therefore, the embankment will be reinforced with a sea wall. The seawall will not only allow for the replacement of the underground utilities, it will also allow for additional green space to be created overlooking the lake. Updates will also be made to the flow of traffic, overall parking plan, walkability and visual appeal of Lakeshore Drive. The project can be broadly classified into three main components:

  1. Slope stability on the lake side
  2. Infrastructure improvements: roads, underground pipes, drainage improvements
  3. Landscape architectural enhancements to develop the corridor as a linear parkway connecting Kinosoo Beach and Cold Lake Marina

The project is separated into three phases:

  1. Phase 1A – includes the installation of a sheet pile wall, erosion protection, and general grading behind the wall from 2 Avenue to 7 Avenue. Phase 1A has been awarded to Chandos Construction.
  2. Phase 1B – will include the deep underground utilities replacement, road and sidewalk rehabilitation, and landscaping from 2 Avenue to 7 Avenue. This work will be tendered in early 2024 for construction in summer 2024.
  3. Phase 2 – includes the deep underground utilities replacement, road and sidewalk rehabilitation, and landscaping from 7 Avenue to 7 Street. This work will follow phase 1 provided funds are available.

Construction on Phase 1A is expected to start September 25 2023, and scheduled to be completed by mid June 2024. It is anticipated that Phase 1B will start in spring of 2024.

Road closures will be in place during construction. Due to the extent of work, Phase 1A will be split into three zones from block to block. The zones that are not under construction will be open for public use.

Pedestrian access will be maintained to the local residents. Other pedestrian traffic will be directed away from the work zone.

The current engineering estimates are approximately $25 million for all phases.

No. Phase 1A of the project is already approved in the 2023 capital budget, and will not result in a further tax increase. A large portion of the project is funded through the Cold Lake Air Weapons Range funding.

Residents affected by the work shall put out their waste, organics, and recycling to their curb or as near as possible on their normal collection day. The contractor will ensure that waste, organics, and recycling is moved to the project limits for collection by City staff. Residents are encouraged to write their address on their bins in the designated area.

Phase 1A will not interrupt any services.
Phase 1B and 2 will include temporary water shutdowns (up to 12 hours) required for the project start up. Temporary water connections will be provided to all residents through an above ground connection, and the contractor will be responsible for managing the sewer flows. The billing of services will be based on the average historical usage for the same month of the past 3 years.

Yes. The contractor will maintain the temporary road to keep the dust down during construction.

Residents are requested to park on a side street or within the zones that are not under construction. Notification and signage will be placed prior to closing the road and during the shifting of work zones.

Phase 1A should not include any damages to the properties.
Landscaping will be restored near the end of the project to the same or better condition as the start of the project.
Driveways will be restored as the road and sidewalk surfaces are restored.

Yes. There will be noise created from the required construction equipment and a drilling rig. The construction equipment is permitted to work from 7 a.m. to 7 p.m. Monday to Saturday and 9 a.m. to 5 p.m. on Sunday and holidays if required.
